Mimico GO: Are station & cemetery slipping into ‘the hole’?

“Are station & cemetery slipping into ‘the hole’?”

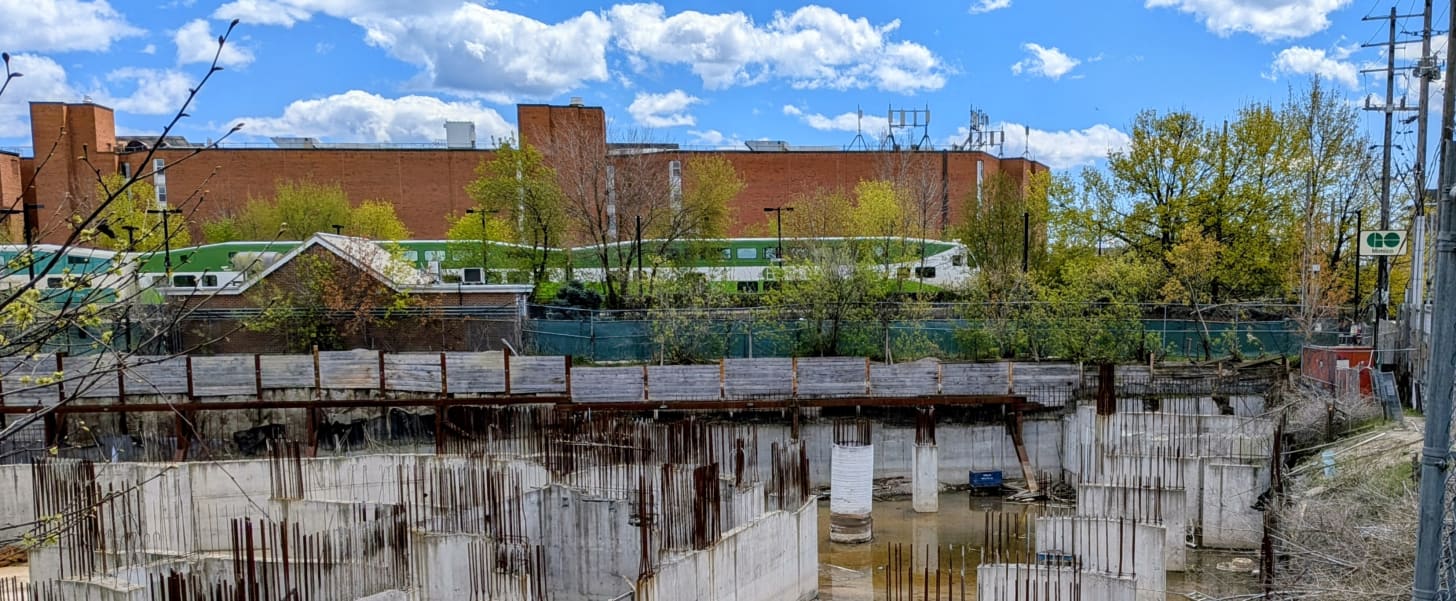

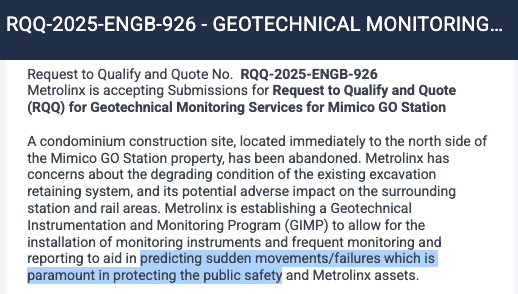

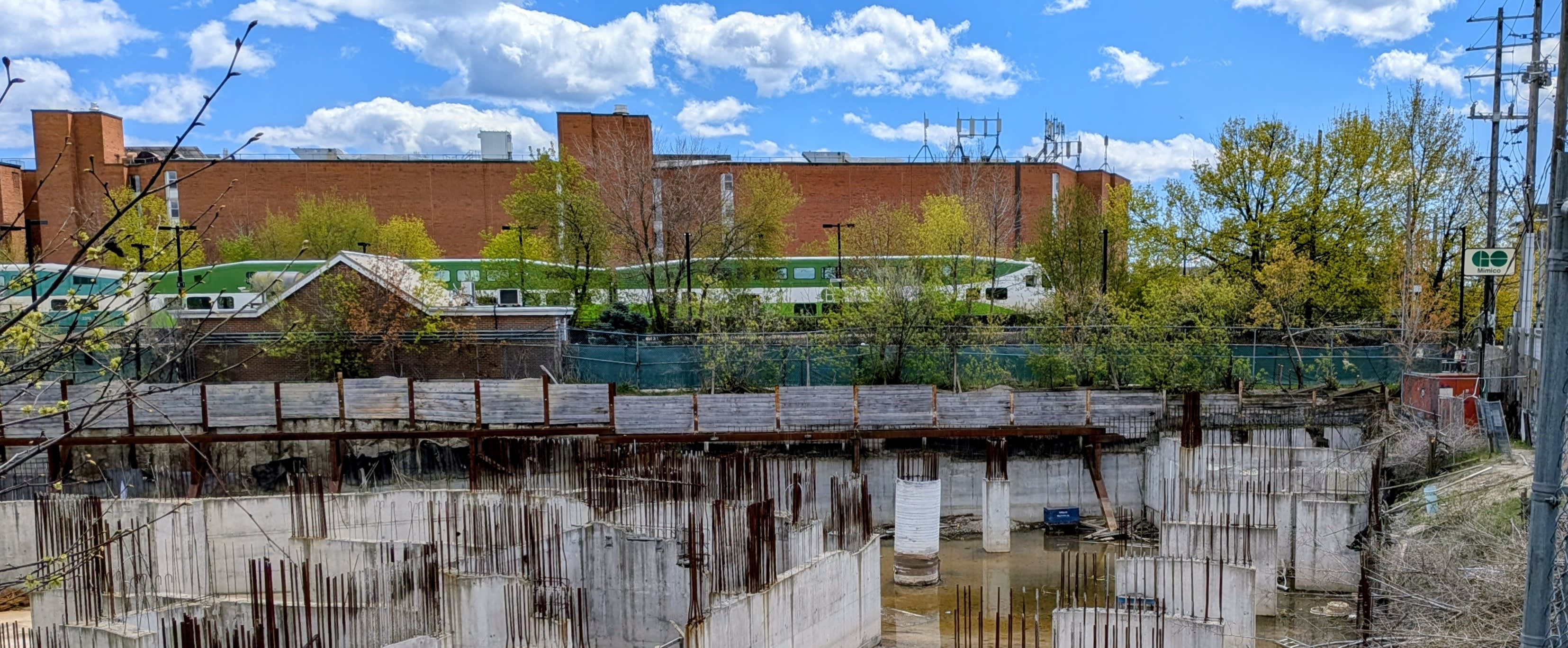

💰 Is the Ontario taxpayer going to get reimbursed for safety monitoring an excavation owned by “Canada’s Leading Private Equity Real Estate Investment Firm”?

MERX Metrolinx Procurement Platform, click on “See More” to see this.

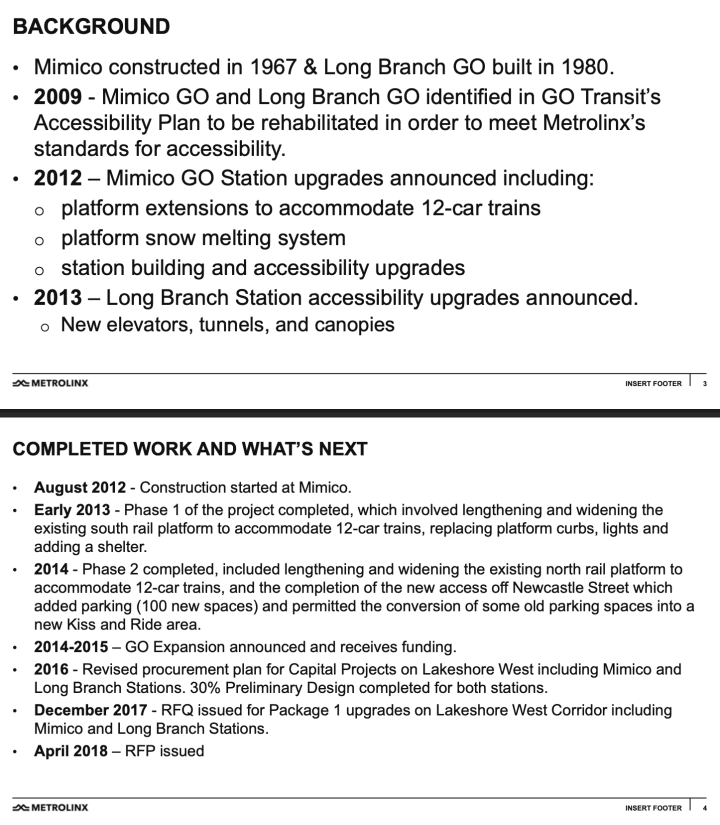

“How did the 2018 plan derail?”

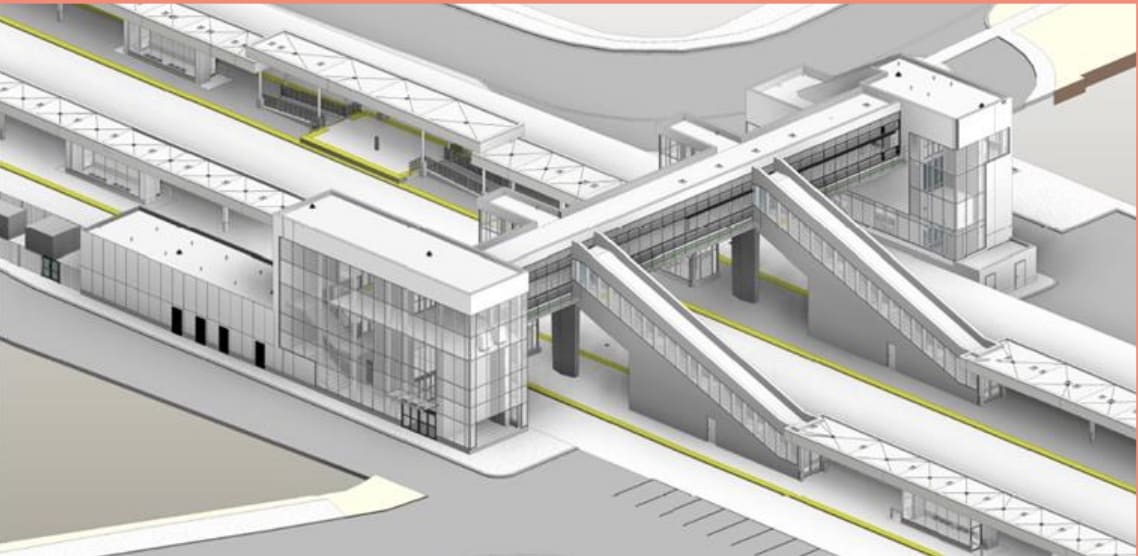

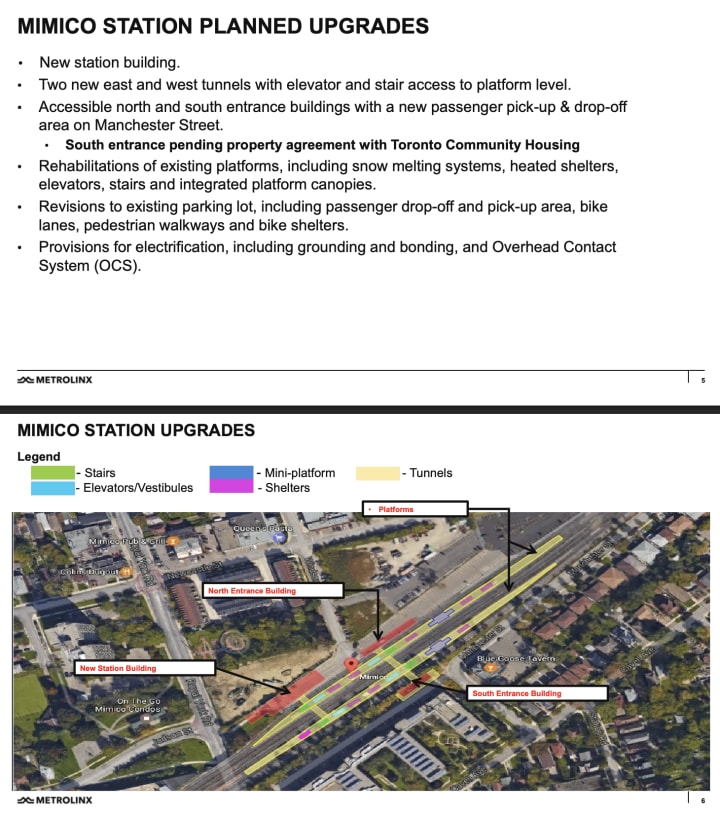

In June 2018, Metrolinx presented a procurement-ready plan for a new Mimico GO station building and two new tunnels with elevators.

According to the Auditor General, in November 2018 — a few months after Ford took office — the Ministry of Transportation directed Metrolinx to stop procurement of new GO stations and adopt a “market-driven strategy.” John Yakabuski, Christine Hogarth, Kinga Surma, Steve Clark and Phil Verster came to Mimico GO Station to announce their Mimico Transit-Oriented Community (TOC) plans with Vandyk.

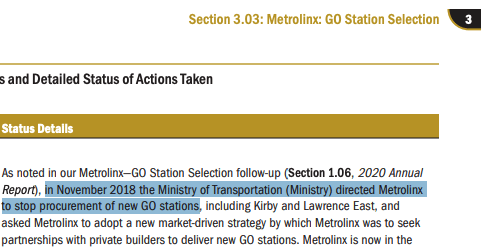

In 2018 Metrolinx was ready to procure the new Mimico GO Station they have been designing since 2016, but got stopped by the Ministry, according to the Auditor General Report: “the Ministry of Transportation (Ministry) directed Metrolinx to stop procurement of new GO stations … and asked Metrolinx to adopt a new market-driven strategy…”

“It’s just a few stairs …”

  • No; It’s discrimination of residents with disabilities.


“I don’t take the train, why would I care?”

  • A well-run transit system accessible for everyone reduces traffic on our roads.


“Are we receiving value for money?”

  • The Ontario government is spending your provincial income tax and HST (the 8% you pay on top of most things you buy) to subsidize Metrolinx with about one billion dollars per year.

  • How many of your tax dollars were lost when the 2016-2018 tunnel plan that already had 30% Preliminary Design completed was thrown out?

  • How much Metrolinx, Infrastructure Ontario / Ministry resources got used in the creation and the termination of the Vandyk TOC (lawyers, planners, engineers; external & internal)?

  • Do you think South Etobicoke has gotten its fair share of Metrolinx infrastructure investments?

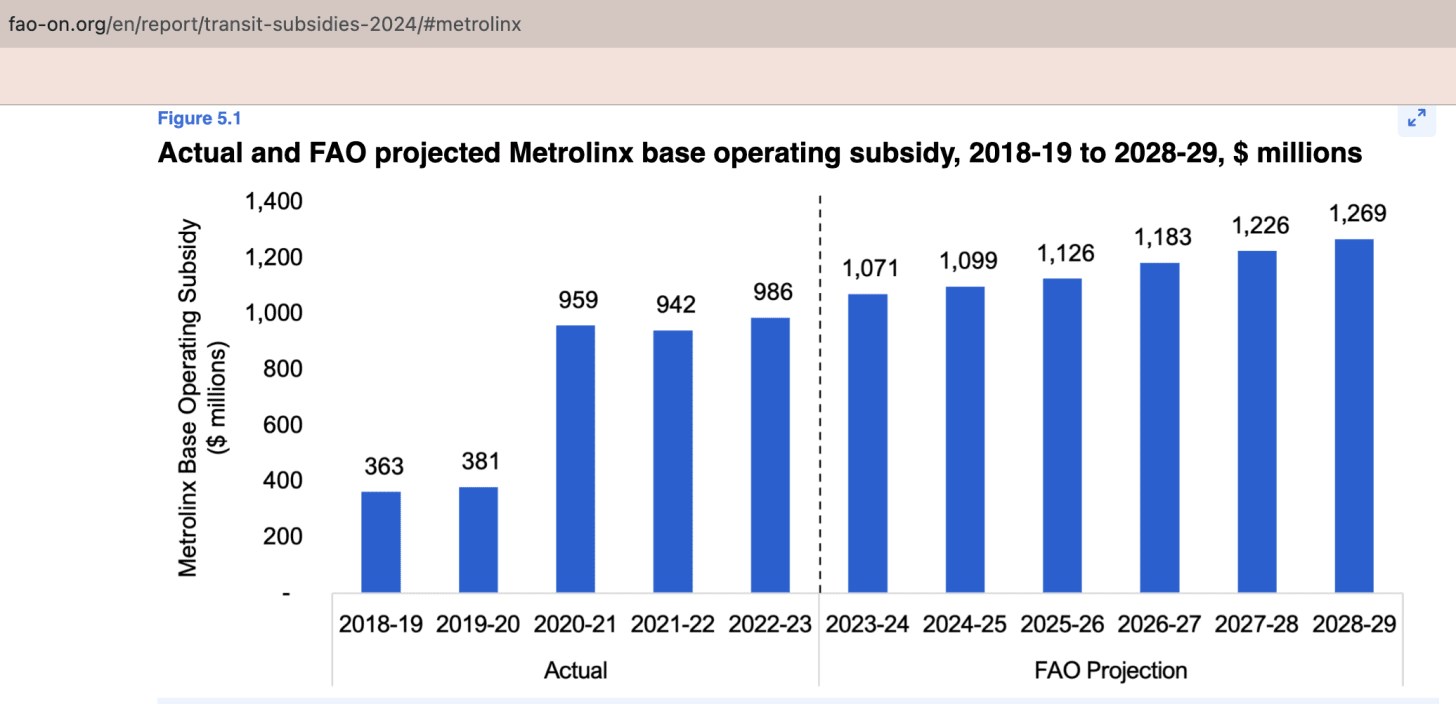

Metrolinx subsidy

“But they showed a new bridge design for Mimico”

  • Yes, but the construction hasn’t been approved and Metrolinx doesn’t share a timeline. If there is a timeline, why won’t they share it?


“But they said they are working on it.”


“How many stairs does the new bridge design have?”

  • A bridge over electrified tracks means 2-5 flights of stairs up and over the overhead wires and back down to the platform. The tunnel didn’t need much of a ramp as the south side of the rail corridor is already below the railway tracks and from below you need much shorter stairs and elevators to the platforms. Fewer stairs are great when the elevator is broken or too busy at rush hour.

  • The original tunnel plan wasn’t just about reaching the platform — it was meant to be an alternative crossing of the rail corridor as well to unify Mimico, creating a connection for the thousands of new residents in the triangle to reach our waterfront.

  • Will this newly proposed bridge be inside a fare-paid zone, or open to anyone who needs to cross the tracks?


“But isn’t it the developer’s fault who went bankrupt?”

  • What due diligence and risk assessment was done before the Ontario Government presented Vandyk as their partner for a project of such significance for our community?

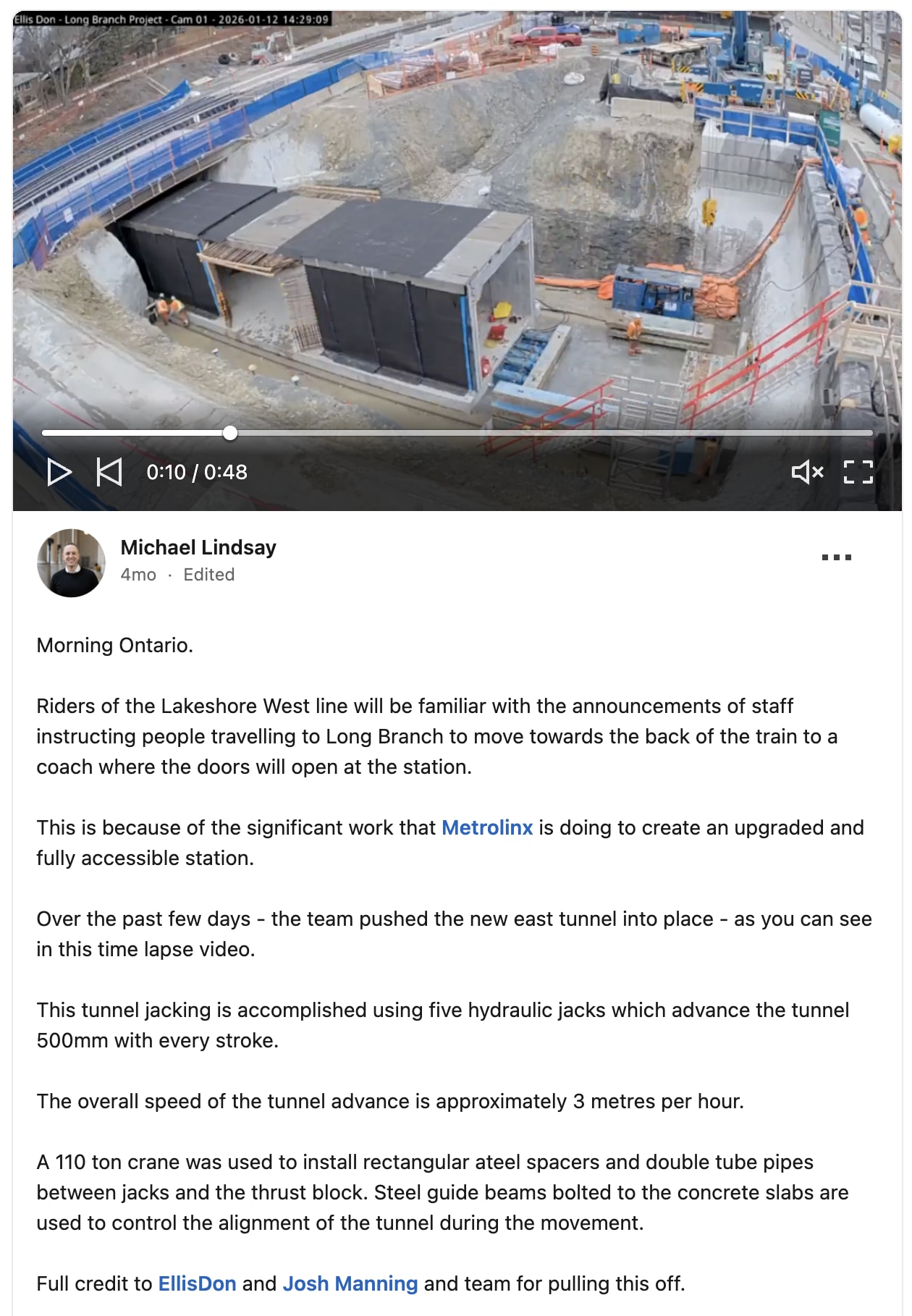

“But they are building tunnels at Long Branch GO, why not in Mimico?”

  • We don’t know.


“Do you need help with this?”

“Who is coming to the Mimico Transit Forum?”

Confirmed:

  • Metrolinx

  • Councillor Amber Morley

  • MPP Lee Fairclough

  • Residents with disabilities

“What are we going to talk about?”

  • About the importance of accessible transit.

“Are we going to do this every year?”

  • Seems like we have to.


Have a nice day, Mimico!
